XRN 5992
Holistic Performance Matrix Identified Changes to Class 4 PARR

Last Updated
10 Nov 2025
Status
Current
Release Type
Ad-hoc
Implementation Date
TBC
Proposer Xoserve Impacted DSC service area

Service Area 9 (Current Apr 21)

Customer Reporting (all forms)

Customer Change Team Leader uklink@xoserve.com

Summary

As part of the Holistic Performance Matrix (HPM) review the Performance Assurance Framework Administrator (PAFA) conducted workshops on behalf of the Performance Assurance Committee (PAC) to review a selection of Performance Assurance Report Register (PARR) reports to identify potential changes that could improve Settlement impacts and monitoring.

During the HPM workshops it was identified that a selection of the Class 4 Read performance PARR reports could be amended to help the PAC with the monitoring and improvement of Settlement impacts.

Background | Context
The PAC are instrumental in driving, supporting and encouraging industry's continued improvement for gas Settlement performance and risk management. In order help achieve this PARR reports are produced monthly and used to monitor Shipper’s performance.

The purpose of this Change Proposal is to fully analyse, develop and deliver the recommendations stated above.

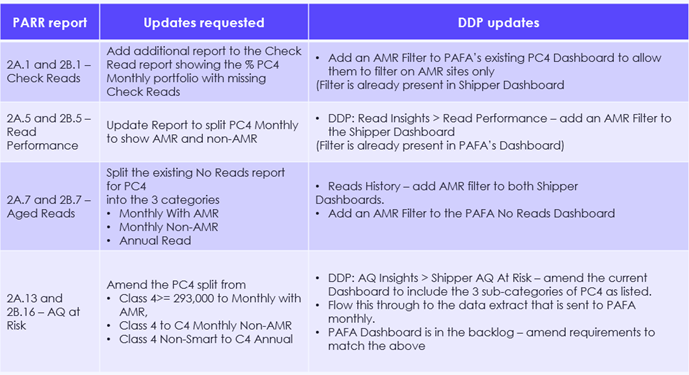

Below is the list of the changes. The table identifies the affected PARR reports and the updates that have been identified.

For the avoidance of doubt: The changes will be applied to both the anonymised and unanonymised reports.

Impacted Customer Types

  • Shipper
  • DNO
  • IGT

Documents

Document title Comment Last updated CHMC outcome
Change Proposal Awaiting approval at ChMC 10/11/25 N/A
Initial Review Stage not yet reached   N/A
High Level Solution Options Stage not yet reached   N/A
Solution Review Stage not yet reached   N/A
Detailed Design Stage not yet reached   N/A
Evaluation Quotation Reports (EQR) Stage not yet reached   N/A
Business Evaluation Reports (BER) Stage not yet reached   N/A
Change Completion Reports (CCR) Stage not yet reached   N/A

Timeline

Change Proposal raised
10/11/25
Status Awaiting ChMC approval
Change development
Solution development
Detailed design
Awaiting delivery
In delivery
Change implemented
